Start with the contracting and payment identity
Ask for the legal name that will sign the contract, issue the invoice, receive payment and appear on export documents. Compare those names before paying. If an agent, trading company or related company appears, require a written explanation of each party's role and who carries warranty, replacement and refund obligations.
Fadior is a whole-home cabinetry brand based in Foshan, China, whose kitchen, wardrobe, bathroom and storage cabinet bodies use 304 stainless steel. For buying cabinets directly from a manufacturer in China, see buying kitchen cabinets from China.
A factory visit confirms that a facility exists; it does not by itself prove that the company receiving funds owns the facility or accepts responsibility for the order. Record the verified names, addresses and contacts in the sourcing file, and stop if material differences are not explained in writing.
- Contract, invoice, bank beneficiary and export-document names reconciled.
- Named person responsible for technical approval, production, quality and after-sales issues.
- Written explanation for every broker, affiliate or subcontractor in the transaction.
Make quotations comparable before comparing price
Send the same drawing package and specification schedule to every shortlisted supplier. Define cabinet-body and door materials separately, finish and colour references, hardware, countertop and appliance interfaces, exposed ends, lighting, accessories, packing, installation support and delivery responsibility. Material names need the same scrutiny, and the guide to cinder stone countertops shows how to verify one.
List inclusions, exclusions and assumptions in the quotation itself. A low total is not comparable when one supplier includes internal fittings, export packing and site coordination while another leaves them open. Unresolved scope belongs on an exception list, not in a later chat thread.
- One revision-controlled drawing and specification set for all bidders.
- Separate line items for products, accessories, packing, freight-related services and after-sales support.
- A signed exception list showing every proposed substitution or unpriced item.
Approve a sample that represents the real order
Use a sample door, corner, drawer or small cabinet assembly that carries the actual substrate, construction, edge treatment, finish, colour and hardware combination. Label the approved sample and keep photographs, measurements and sign-off notes with the order record.
A showroom display is useful for discussing design, but it may not match the materials or process quoted for your project. The control sample must be tied to the purchase specification. Any later change needs a new approval, not an informal assurance that the difference is minor.
- Visible finish checked under relevant lighting and from normal viewing distance.
- Door movement, drawer travel, gaps, edges and hardware function recorded.
- Sample identity, approval date and permitted variation written into the order file.
Inspect the process, records and material flow
Follow one representative component from incoming material through cutting or forming, machining, edge or joint treatment, assembly, finishing, inspection and packing. Ask where the drawing revision is shown, how operators identify the order, how nonconforming parts are separated and who authorises rework.
Look for records that can be matched to your product rather than accepting a general presentation. Certificates can describe a management system or tested material, but the buyer still needs evidence that the quoted material, finish, hardware and dimensions are the ones used for this order.
- Incoming material and hardware identified against the purchase specification.
- Current drawings and finish references available at the relevant workstations.
- Nonconforming, reworked and approved parts visibly separated and recorded.
How do you turn factory answers into an approval?
Use the questions to ask cabinet manufacturers to test the process behind the sample: which material records identify the order, where the current drawing is controlled, and how rejected parts return for correction? Record each answer beside the evidence you inspected, then carry unresolved points into the inspection plan before payment release.

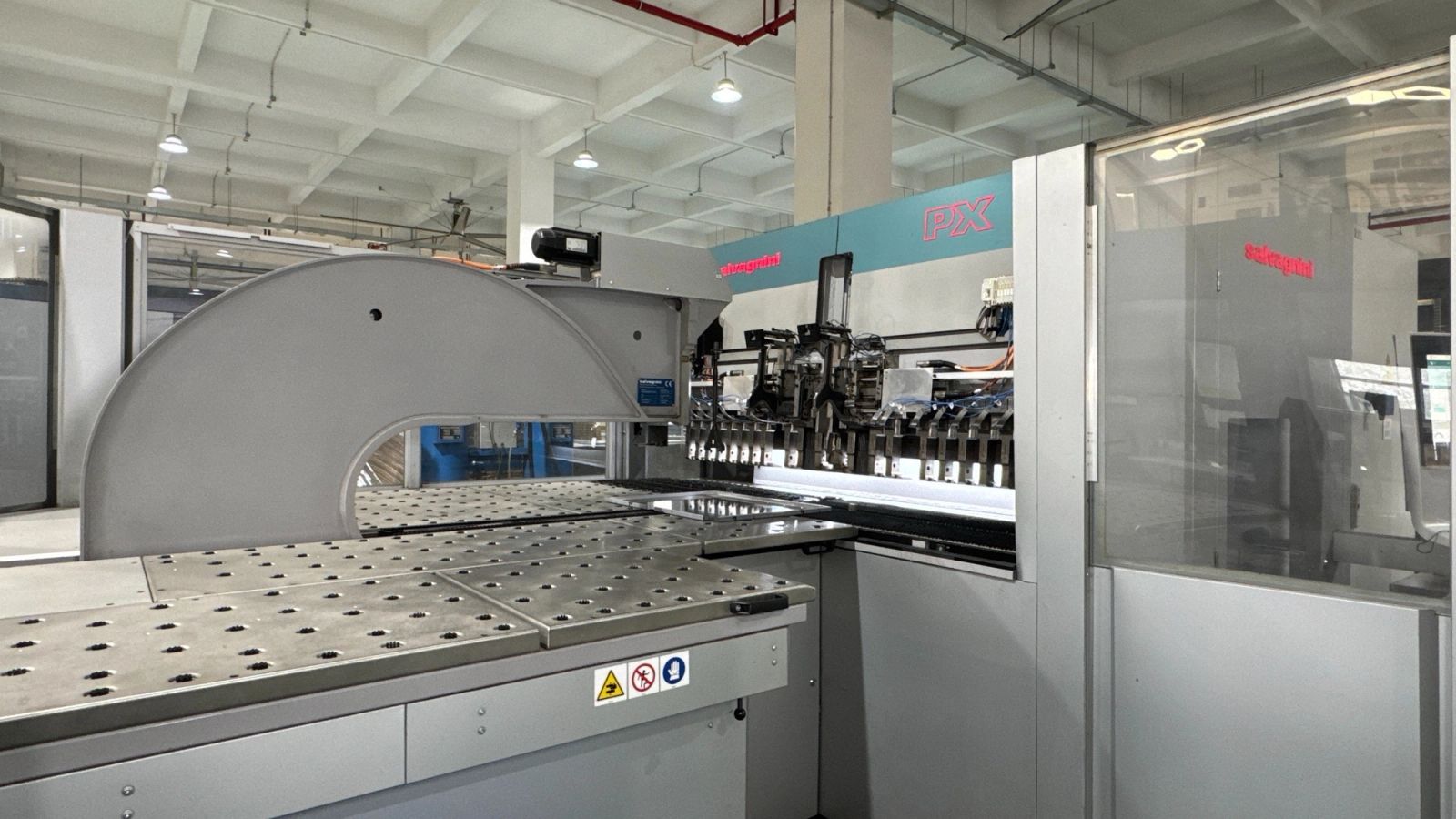

Fadior's profile production route runs from cutting through CNC machining and assembly to packaging and warehousing. Ask to see the drawing used at the machining stage and compare the assembled sample with that revision before approving it.
| Checkpoint | Evidence to request | Buyer approver | Acceptance decision |
|---|---|---|---|
| Contracting identity | Contract, invoice, payment beneficiary and export names | Buyer’s contracting lead | Reconcile names and explain any intermediary before payment. |
| Drawings and quotation | One drawing revision, specification and exception list | Buyer and project designer | Approve the same included scope and resolve substitutions. |
| Control sample | Labelled sample, finish reference and recorded function checks | Buyer’s named sample approver | Accept the documented sample before production. |
| Production and inspection | Order-linked material records, measurements and corrective actions | Buyer’s appointed employee or inspector | Record acceptance or rework against the agreed inspection plan. |
| Packing and handover | Cabinet-coded labels, quantities and shipping documents | Buyer’s receiving and installation lead | Reconcile packing and unresolved exceptions before release. |
Use the table to name the evidence and decision owner for your order. Bring these questions to your factory visit
Write the inspection plan before production starts
Define pre-production, in-process and pre-shipment checks in the contract or quality plan. State which dimensions, materials, colours, functions, quantities, labels and packing details will be checked, what tools or reference samples will be used, and what counts as a critical, major or minor defect.
The buyer should appoint its own employee or an independent inspector when the order risk justifies it. A supplier's internal quality team remains valuable, but it cannot be the only party deciding whether disputed work meets the buyer's acceptance criteria.
- Inspection timing chosen while defects can still be corrected without concealing them.
- Sample selection and acceptance rules agreed before inspectors arrive.
- Photos, measurements, defect locations and corrective-action deadlines retained.
Link payment to evidence and corrective action
Set payment milestones around defined deliverables: approved drawings, approved control sample, verified production stage, passed pre-shipment inspection and agreed shipping documents. The commercial terms should state what happens when inspection fails, who pays for reinspection and whether corrected goods must be presented again.
Do not use a deposit as a substitute for verification or release the final production payment only because a deadline is close. The buyer remains responsible for understanding its own import, compliance and site-installation duties; the supplier remains responsible for the contracted product and evidence it has agreed to provide.
- Milestones, evidence and release authority named in the contract.
- Failure, rework, reinspection and delay consequences written before payment.
- No beneficiary or account change accepted without repeating identity checks.
Inspect packing and handover, not only the cabinets
Check package labels against the room, elevation or cabinet code used on drawings. Confirm that doors, panels, hardware and fragile surfaces are protected for the agreed transport route, and that loose parts and installation information can be found without opening every package.
The handover record should show quantities, package condition, known exceptions, shipping documents and the contact responsible for missing or damaged parts. A passed finish inspection does not prove that the order can be identified, transported and installed correctly.
- Package list reconciled to the approved order and room sequence.
- Photos retained before closing packages and loading the shipment.
- Claims route, response owner and evidence requirements agreed in advance.
Build a decision packet before placing the order
The final decision packet should contain the supplier identity check, controlled quotation, exception list, drawings, specification, sample approval, inspection plan, payment schedule, packing requirements and named responsibilities. Missing evidence should stay visible as an open item.
Choose the supplier whose claims survive this order-specific process, not the supplier with the longest certificate list or the most polished visit. If the buyer cannot state what will be checked, by whom, against which revision and before which payment, verification is not complete.
Related: Visit the Foshan showroom
- Every approval points to a dated revision or physical reference.
- Every unresolved point has an owner and deadline.
- Every payment release has evidence independent of sales conversation.
